RIGHT OF WAY PERMITS
PUBLIC WORKS
- Public Works
- 50/50 Sidewalk Replacement Program
- Backup Control Measures
- Belvidere Stormwater Fee Survey
- Belvidere Waste Water Survey
- Branch Collection
- Emerald Ash Borer-Fact Sheet
- Leaf Collection
- NPDES / Stormwater
- Right of Way Permit
- Sidewalk and Driveway Specifications
- Snow Plowing Policy
- Truck Route Information
- Water Bill Pay
- Water and Sewer Rates
- Water & Sanitary Sewer Construction
- Water Quality Report
- Home
- >
- Right of Way Permit
RIGHT OF WAY PERMITS
A Right-of-Way (ROW) Permit is required for work performed within the City of Belvidere public right-of-way. This includes utility, telecommunications, fiber, gas, and other construction or installations that may affect City streets, sidewalks, parkways, or other public infrastructure.
All work within the City’s right-of-way is subject to City review and approval. An approved ROW Permit must be issued prior to beginning work.
Permit Application
Applicants must submit a completed City of Belvidere Right-of-Way Permit Application along with plans or drawings showing the proposed work.
Plans should clearly identify, as applicable:
- Project location and limits of work
- Proposed utility or cable alignment
- Installation method and depth
- Roadway and sidewalk crossings
- Bore, trench, or excavation locations
- Handholes, vaults, structures, or other proposed facilities
- Pavement, sidewalk, curb, or parkway impacts
- Proposed restoration
Standard contractor construction drawings are acceptable provided they contain sufficient information for City review.
Insurance Requirements

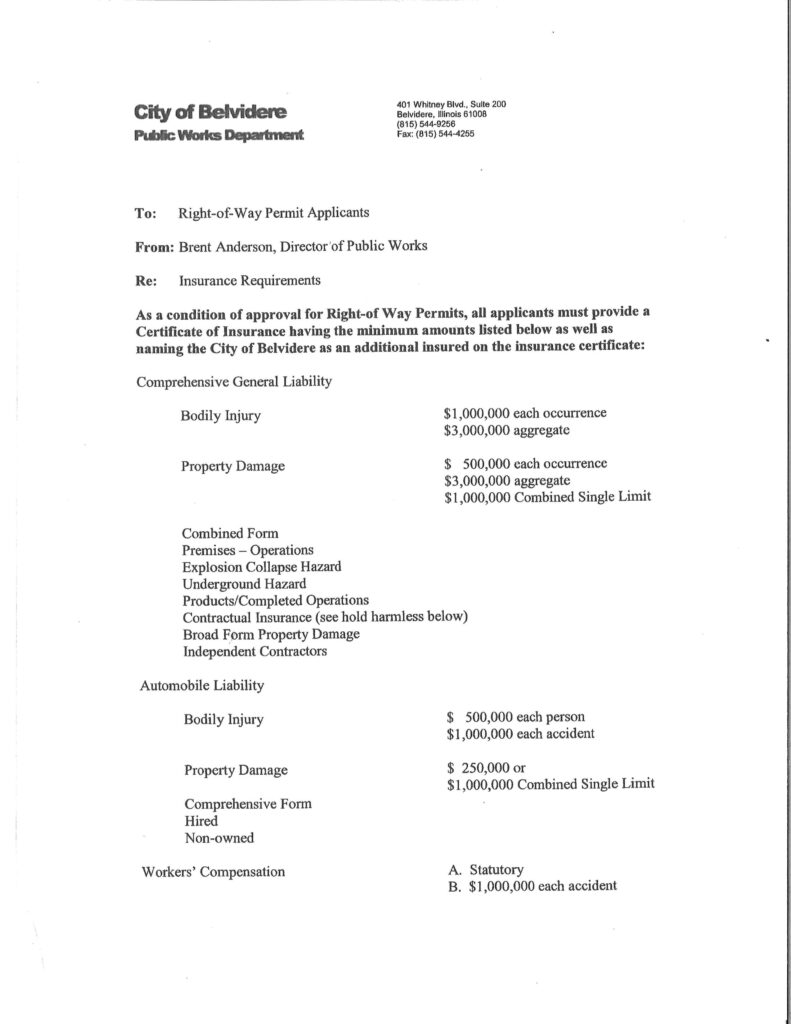

As a condition of ROW Permit approval, all applicants must provide a current Certificate of Insurance (COI) meeting the City’s minimum insurance requirements and naming the City of Belvidere as an additional insured.
Required coverage includes:
- Comprehensive General Liability
- Automobile Liability
- Workers’ Compensation
The City’s insurance requirements identify the required coverage types, minimum limits, and other applicable provisions. Applicants should review these requirements prior to submitting a permit application to avoid delays in approval.
Submit Your Application
Please email the following documents for review:
- Completed ROW Permit Application
- Proposed plans or drawings
- Certificate of Insurance meeting City requirements
- Required performance bond, if applicable
Submit all materials to:
Nicole Lewakowski
Assistant Director of Public Works
NLewakowski@BelvidereIL.gov
Incomplete applications or missing insurance documentation may delay permit review and approval.
City Utility Information
City staff will review the proposed work for potential conflicts with public infrastructure. Available City utility atlas information may be provided for design and construction reference when applicable.
City utility information is approximate and does not replace required field locating or verification. Contractors are responsible for contacting J.U.L.I.E. and verifying existing utilities prior to construction.
Permit Review & Approval
Once the completed application, plans, and required insurance documentation are received, City staff will review the proposed work and provide any additional requirements or comments specific to the location.
Revisions may be required based on existing City utilities, proposed pavement or sidewalk disturbance, restoration requirements, or other site-specific conditions.
Applicants planning larger utility projects are encouraged to submit preliminary or pre-final plans for City review prior to formal permit submittal.
Work may not begin until an approved ROW Permit has been issued by the City.
Construction Requirements
All work shall be completed in accordance with the approved permit, submitted plans, applicable City requirements, and City specifications.
The proposed installation shall maintain a minimum 5′-0″ horizontal and vertical clearance from all public utilities, including water, sanitary sewer, and storm sewer, unless otherwise approved by the City.
Traffic control shall be provided as required. Any pavement, sidewalk, curb, parkway, or other public infrastructure disturbed during construction shall be properly restored upon completion.
Roadway openings or pavement disturbance require specific City review and approval and shall not be performed unless included in the approved permit.
Questions?
For questions regarding ROW Permit requirements or the application process, contact:
Nicole Lewakowski
Assistant Director of Public Works
NLewakowski@BelvidereIL.gov
815-544-9256
